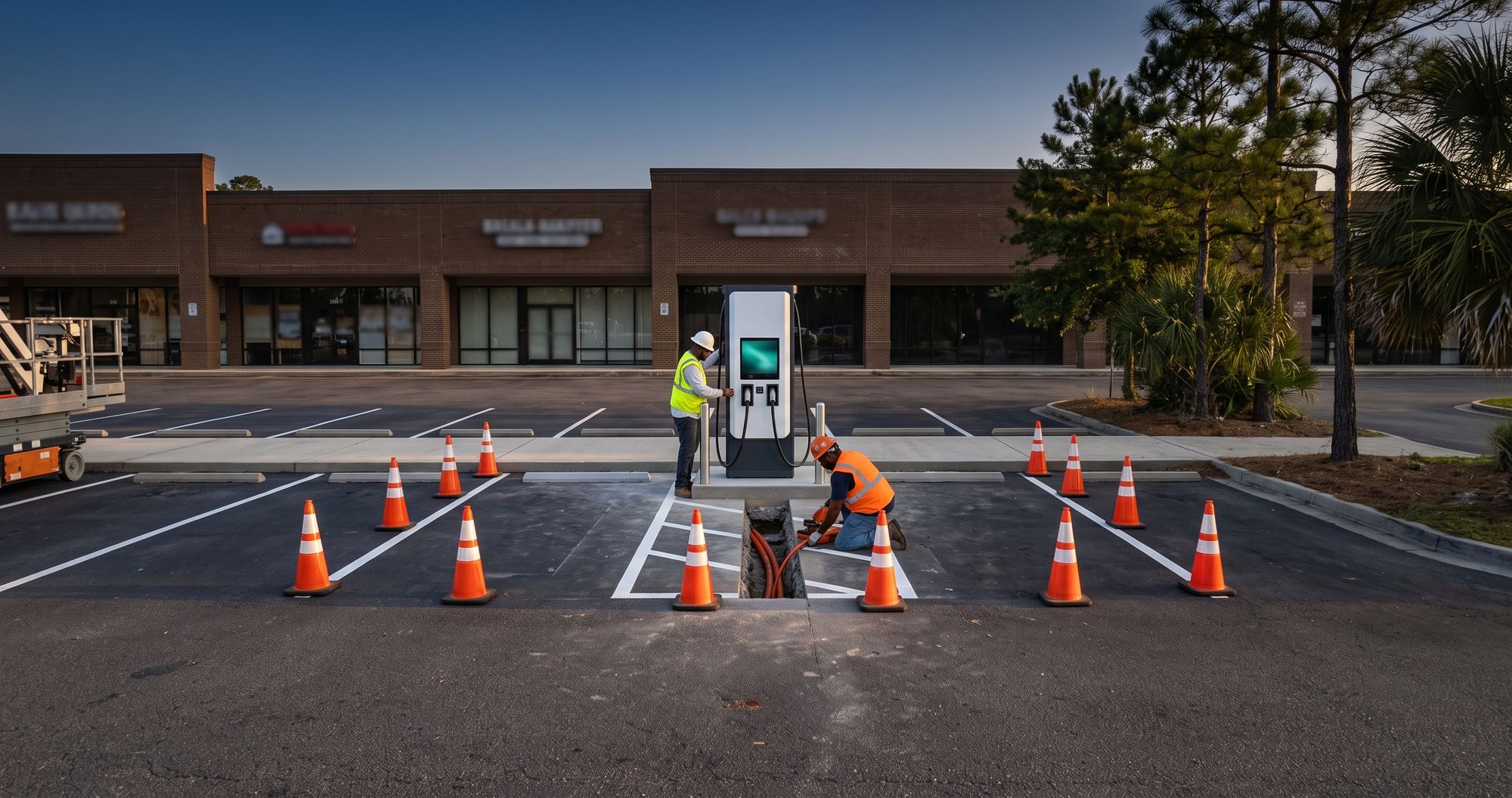

A charging build is a general-contracting problem, and you assemble none of it. Here is the whole sequence, and the build itself opened up — what open book actually means, a real two-stall configuration line by line, and the schedule the management fee is worked out on.
On paper a charging build is a general-contracting project — utility paperwork, equipment specs, an engineer, an electrician, an equipment vendor and a network operator. Let our team turnkey your project, or manage the build yourself once the charging solution is identified. The first two steps are free; costs enter only when you decide to move, and you see them.
Worth knowing which of these you could scope yourself: steps 3 and 4 are licensed work — a stamped drawing needs a licensed engineer and the utility interconnection needs a contractor, no matter who you hire. Steps 1, 2 and 6 are not. Any owner can pull their utility's DCFC rate schedule, ask the utility for a service-capacity letter on the address, and claim the site on the map apps drivers use. Do those three and you'll read every quote you get — ours included — far better.

It means you see the actual subcontractor contracts. Not a summary of them, not a line on our proposal that says what they came to — the documents themselves, for the electrical, the civil work, the equipment. The build price is built up from those, so every number in it has a contract standing behind it that you can read.
That is the whole test, and it is a document test rather than a wording test. A lump sum tells you what the job costs and nothing about how it got there; an open book hands you the inputs and lets you check the arithmetic yourself. It is also why the range on the Solutions page is a range — the contracts on a lot with a short run and spare service capacity genuinely read differently from the ones on a lot that needs a transformer and 300 feet of trench.
Which gives you the question to put to anyone who uses the phrase, us included: which documents do I actually get to see, and when do I see them? Ask it before you sign anything, with us or with the contractor down the road. An open book you are only told about after the work is done is a report, not an open book.
It is the question everybody asks, so here is one real configuration end to end: a single 200 kW charger serving two stalls at a retail site, running on Connect 10 — the build behind the ~$125,000 to ~$190,000 range quoted on the Solutions page.
Two numbers, not one, because the equipment barely moves and the construction does. The charger barely moves next to what the ground does. What separates the bottom of that range from the top is mostly the hundred feet of dirt between your electrical service and the parking stall — and that is a fact about your property, knowable before anyone quotes you.
| What it is | What it costs | When you pay it | Needed? |
|---|---|---|---|
| EquipmentOne 200 kW charger, two stalls | ~$67,000 to ~$80,000Moves with output, cable count and whatever the manufacturers are running — but far less than the construction does | Once, up front | Required |
| Construction & installationMake-ready, trenching, conduit, transformer, energization — run open book, what that means → | ~$58,000 to ~$110,700The part your property decides. Managing the program is inside this number, not added to it | Once, up front | Required |
| The build, togetherWhat the two lines above come to | ~$125,000 to ~$190,000Before incentives — utility make-ready and state rebates come off this | Once, up front | Required |
| PlatformAccess, pricing, payments, monitoring, 24/7 driver support — what the platforms do → | Connect 10: from 5.775¢ per kWh soldData and card processing are inside that numberOr Tap-N-Charge for card-only: a $0.75 session fee and 6.9% deducted, nothing recurring — the same structure on a DC site as on Level 2 | Ongoing — only on power actually sold | Required |
| VoltCareAdvance exchange, so a failed unit is replaced rather than queued for repair | From ~$200/yr on Level 2 up to ~$10,000/yr on DC |
Ongoing — annual, or prepaid by term | Optional |
| Recharge LabsTargeted marketing, campaigns, listings, loyalty | From ~2.5¢ per kWh sold | Ongoing — only on power actually sold | Optional |
Read down the “when” column and the answer is: one large number at the start, and two small ones per kilowatt-hour afterwards — both of which are zero on a stall nobody used. Add the two together and, with the optional marketing layer switched on, under 8.5¢ of every kilowatt-hour you sell goes to running and promoting the station: 5.775¢ for the platform, about 2.5¢ for the marketing, card processing already inside the first one. There is no monthly subscription on a fast-charging build and nothing here is billed per port. VoltCare and Recharge Labs are genuinely optional — the station runs without either.
Two things this deliberately doesn't do. It doesn't tell you what the site earns — that depends on your traffic and your tariff, which is what the free evaluation is for. And it doesn't tell you where in the range your lot lands: that is what the table below is for, and it is worth putting to every bid you take, ours included. Ask any builder which of these four conditions they assumed, because a number quoted on the best case is not a number you can budget against. On Level 2 the shape is different again — Connect 10 is a flat $199/yr per site plus $199/yr per charger, a Tap-N-Charge unit has nothing recurring at all, and if you are not charging for the electricity there is no platform fee either (the platforms, side by side →).
None of them is about the charger. All four are facts about your property that you can check before you talk to anybody — and any one of them going the wrong way moves the number more than picking a different brand of equipment ever will.
| What decides it | Pushes toward ~$58,000 | Pushes toward ~$110,700 |
|---|---|---|
| Service capacitySpare amperage already at the property | Enough headroom in the existing service to carry the charger | A service upgrade, and the utility work and lead time that comes with it |
| TransformerWho supplies it and where it sits | Utility-side transformer already adequate — nothing new on your pad | A new pad-mount transformer, its pad, and its protection |
| Run lengthDistance from the panel to the stall | A short run — the stalls sit near the electrical room | A long run across the lot, in bigger conductor, priced by the foot |
| Civil workWhat the conduit has to cross | Little or none — an open route, minimal restoration | Trenching, saw-cutting and repaving asphalt or concrete, islands, bollards, striping |
Read it as a checklist on your own property, in that order. Walk from your electrical room to the stalls you would use and count the feet, note what the route crosses, and ask your utility two questions in writing: how much spare capacity the service has, and whether the transformer serving you can carry another 200 kW. Those answers place you on this table before a single quote arrives — and they are the same four conditions on a Level 2 build, at a smaller scale, since the conduit does not care what is on the end of it.
Equipment at ~$67,000 is the two-stall 200 kW configuration priced above; commissioning, construction and installation are the balance. Ranges are before incentives — utility make-ready programs and state rebates come off the total, and the free evaluation prices yours.
The two-stall 200 kW build at the higher end of the range on the Solutions page — the one with trenching and a transformer in it. Three lines, and they add to the total. Our fee is one of them, not something added after it.
| What it is | What it costs |
|---|---|
| Equipment The charger itself, delivered | $67,000 |
| Commissioning Configured, tested and brought into service | $2,700 |
| Make-ready, site work and installation Service, trenching, transformer, conduit, pad, the electrical run and setting the unit — the subcontractor contracts you get to read | $98,771 |
| Construction management Us running it: scope, bids, schedule, inspections, energization | $11,888 |
| The build, together Before incentives — utility make-ready and state rebates come off this | $180,359 |
That management line is 12.0% of the work it manages, and 6.6% of the build. It is charged on construction and installation only — never on the equipment, which we do not mark up a second time for managing.
A flat $1,699, plus a percentage of the construction and installation cost that steps down in bands — the way tax brackets do, not the way a price list does:
| On the construction and install cost | Rate |
|---|---|
| The first $20,000 | 14% |
| $20,000 to $50,000 | 10% |
| $50,000 to $100,000 | 9% |
| Above $100,000 | 7% |
Each band only applies to the money inside it. The first $20,000 is charged at 14% on a $30,000 job and on a $300,000 one; only the money above each line moves to the next rate. That is deliberate, and it is what stops the edges being strange — there is no point where one more dollar of scope suddenly cuts the fee on the whole job, and no reason for anyone to shave a bid to land under a threshold.
Worked on the build above: 14% of the first $20,000, 10% of the next $30,000, 9% of the next $50,000, and 7% of what is left, plus the $1,699 — $11,888 on $98,771 of work. The same schedule applies to a Level 2 build, where the numbers are smaller and the flat fee is a larger share of a small job.
